There is no reliable single all-in cost per square meter for a warehouse in the Philippines in 2026. A useful estimate must define the site, building, technical requirements, and supply scope before applying a unit rate.

One supplier may quote only the fabricated steel frame. Another may include cladding, engineering, doors, windows, packaging, freight, or erection. Foundations, floor slabs, drainage, mechanical and electrical work, fire protection, permits, taxes, and site development may all be separate.

Start With a Defined Cost Scope

Before comparing prices, identify which level of work each quotation covers.

Quotation levelPossible inclusionsCommon items to check separately
Steel package supplyPrimary and secondary steel, connection componentsEngineering scope, cladding, accessories, delivery, erection
Delivered building shellSteel package, roof and wall system, packing and freightUnloading, erection, foundations, floor slab, local taxes
Installed shellDelivered shell and site erectionSite preparation, civil works, services, permits, fit-out
Turnkey warehouseBuilding shell, civil works, services, and agreed fit-outLand, financing, owner-supplied equipment, scope exclusions

A cost-per-square-meter figure is only meaningful when the inclusions, exclusions, design criteria, delivery terms, currency, quotation validity, and treatment of changes are clear. A lower figure may simply cover less work.

For company and market updates, see the Showhoo Building news section.

What Determines Warehouse Construction Cost?

Site and foundation conditions

The building footprint does not reveal what is below it. Soil bearing capacity, groundwater, site level, drainage, and access can materially affect the foundation and ground-floor budget.

A geotechnical investigation should guide the foundation design. Soft or variable ground may require soil improvement or deep foundations, but the need for piles cannot be determined from the city or region alone. The site investigation and structural calculations must establish the appropriate solution.

Wind, seismic, rain, and coastal exposure

Philippine warehouse design must respond to the conditions at the specific project location. Local wind and seismic requirements influence the primary frame, bracing, connections, purlins, girts, fasteners, and foundation reactions. Heavy rainfall also makes roof drainage, gutters, downpipes, flashing, and site drainage important parts of the design.

Coastal exposure may require a more suitable corrosion-protection and maintenance strategy. The correct coating or material system depends on the exposure category, intended service life, fabrication process, and maintenance plan.

Final member sizes and structural parameters must be determined from the building dimensions, local wind and seismic data, applicable design requirements, and structural calculations.

Building geometry and structural layout

Span, eave height, bay spacing, roof slope, column layout, and the number of openings all affect steel weight and fabrication complexity. A clear-span warehouse can improve internal circulation, but a wider span does not automatically produce the lowest structural cost.

A regular grid and repeated connection details can simplify engineering, fabrication, packing, and erection. The layout still needs to suit racking, forklifts, loading docks, production equipment, and future expansion.

Roof, wall, and insulation requirements

A basic dry-storage warehouse may use single-skin roof and wall sheets. A temperature-controlled facility may need insulated panels, vapor control, sealed openings, and coordinated refrigeration or HVAC work. Daylighting panels, ridge ventilators, canopies, doors, windows, and architectural finishes also change the price.

The enclosure should be selected for the stored goods and operating conditions rather than added as a generic upgrade.

Operational loads and fit-out

Warehouse use affects both the structure and the slab. Important inputs include rack loads, forklift traffic, suspended services, fire systems, solar panels, conveyors, automated storage and retrieval systems, cranes, and mezzanines.

These requirements should be identified before structural design. Late changes can affect member sizes, foundations, openings, floor tolerances, and connection details.

Location, freight, and erection

Metro Manila, CALABARZON, Central Luzon, Cebu, other parts of the Visayas, and Mindanao have different land, labor, access, freight, and site constraints. Port handling, inland transport, crane access, storage space, and the availability of an experienced erection team can change the delivered project cost.

Location alone does not determine the foundation or structural solution. A site-specific review is more reliable than a regional cost assumption.

Where the Warehouse Budget Goes

Instead of relying on a universal percentage split, review each package separately.

Cost groupTypical itemsQuestions to confirm
Site and foundationsEarthworks, footings, anchor bolts, slab, drainageIs a geotechnical report available? Who designs and builds the foundations?
Primary steel frameWelded H-section columns and rafters, connection platesWhich design criteria and loads are included?
Secondary steelC/Z purlins, girts, bracing, eave membersAre all secondary members, fasteners, and bracing included?
Roof and wall enclosureProfile sheets or insulated panels, trims, flashingsWhat panel type, thickness, finish, and insulation level are specified?
Openings and accessoriesDoors, windows, skylights, ventilators, canopies, guttersAre quantities, sizes, and hardware defined?
Engineering and documentationStructural calculations, fabrication drawings, erection drawingsWhat documents will be provided for local review and installation?
Delivery and erectionPacking, container loading, freight, unloading, cranes, laborWhere does the supplier’s responsibility end?
Building servicesElectrical, plumbing, fire protection, HVAC, refrigerationAre these excluded from the steel-building quotation?

This breakdown makes quotations easier to compare and exposes scope gaps before a contract is signed.

Real Project Example: 1,375 m² Steel Warehouse in Luzon

Cost estimates are easier to understand when they are connected to an actual project. This 1,375 m² warehouse in Luzon shows how building dimensions, structural design, and local conditions were translated into a completed steel building.

The project was completed in 2021, so it is evidence of engineering and delivery capability rather than a 2026 cost benchmark.

Project itemSpecification
LocationLuzon, Philippines
Completed2021
Building area1,375 m²
Dimensions55 × 25 × 6.55 m
Primary structureWelded H-section steel
Project steel gradeQ355B
RoofCorrugated steel sheet

Project requirements and local design considerations

The customer needed structural calculations and drawings for project review. The warehouse also had to respond to a hot, humid, high-rainfall environment, making structural detailing, corrosion protection, waterproofing, and rainwater management important during planning.

This is why two warehouses with the same floor area can require different structural and enclosure solutions. Location, design criteria, building use, and supply scope matter as much as area.

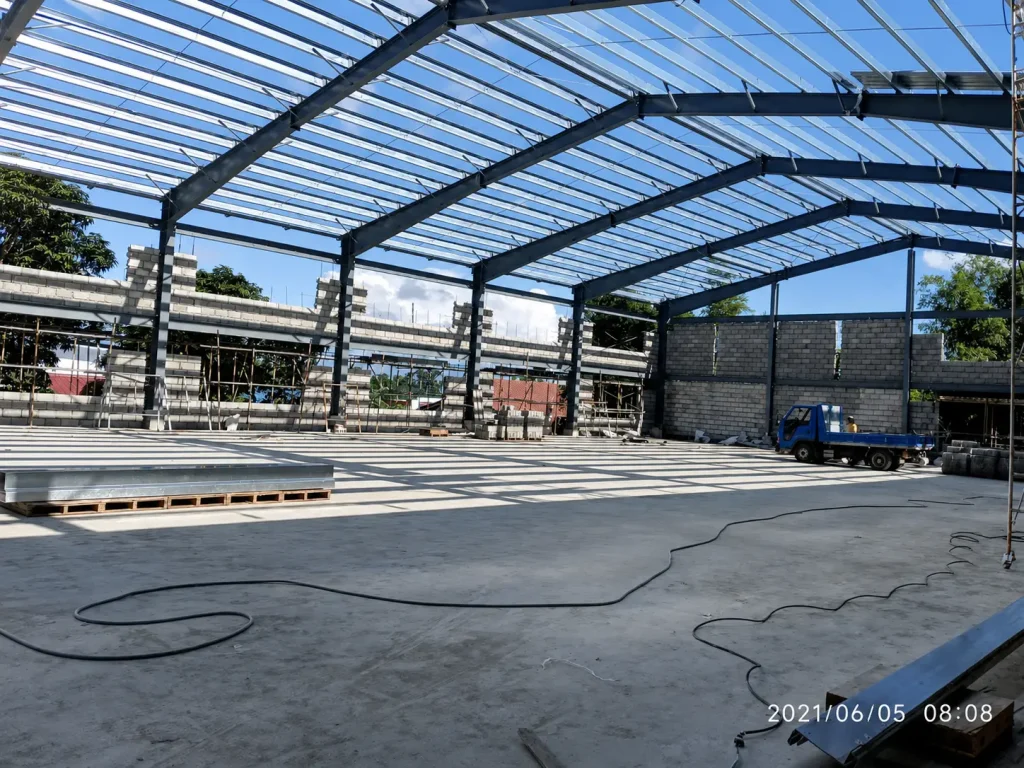

Philippines steel warehouse interior during construction, showing portal frames, roof purlins, wall work and site materials.

From steel frame to completed warehouse

The completed warehouse uses welded H-section steel for the primary structure, corrugated steel roofing, and masonry walls. Its open interior provides a practical storage area with a straightforward structural layout.

Construction-stage and completed-building photos can help a buyer see how the drawings, fabricated components, and site work came together. Image captions should describe only what is visible in each photo.

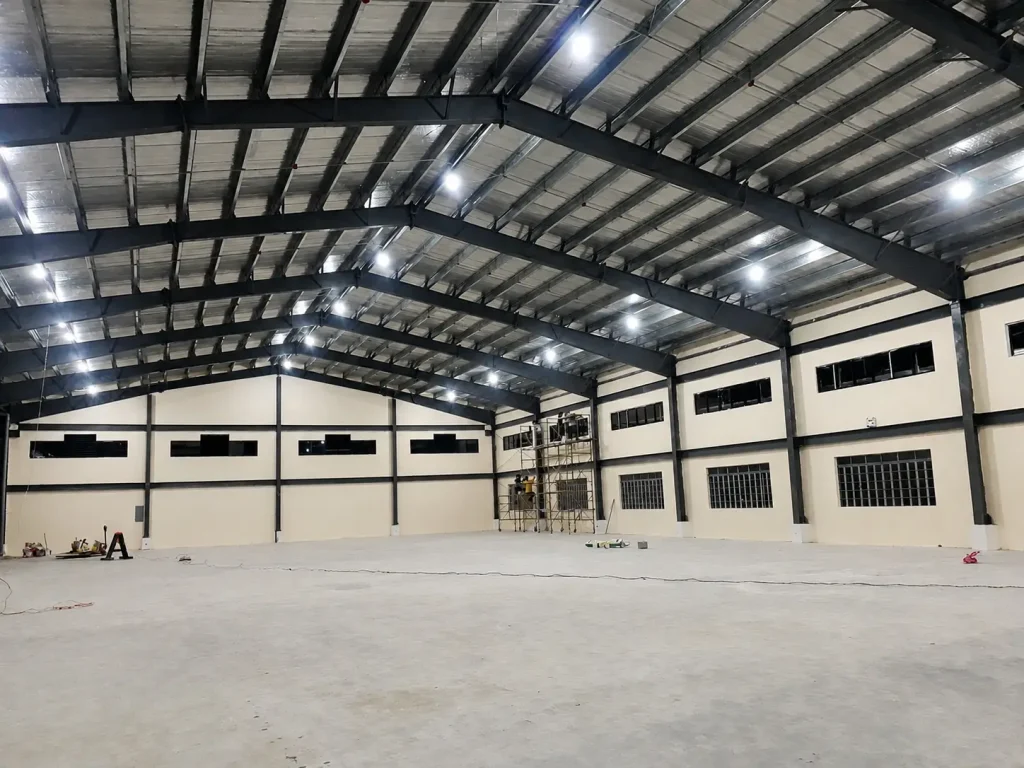

Completed interior of a Philippines steel warehouse with portal frames, insulated walls, bright lighting, and open floor.

What this project means for a new budget

The 2021 project should not be used as a direct PHP-per-square-meter reference for a 2026 warehouse. A current quotation needs the new project’s location, dimensions, structural requirements, roof and wall systems, engineering scope, and delivery terms.

Email: sales@showhoo.com.cn
Phone/WhatsApp: +86 186 7895 5927

Is Steel Cheaper Than Timber or Reinforced Concrete?

No structural system is automatically the cheapest for every site and use. The comparison must use the same design life, loads, fire requirements, enclosure, foundations, installation scope, and maintenance assumptions.

Pre-engineered steel can reduce on-site cutting and simplify erection because the main components are fabricated before delivery. Its strength-to-weight ratio can also support efficient clear-span layouts. These advantages depend on coordinated design, accurate fabrication, suitable corrosion protection, and competent erection.

Timber requires careful treatment and detailing in a humid environment, particularly where termites, persistent moisture, or water ingress are risks. Steel avoids biological decay, but it is not maintenance-free. Coatings, drainage details, damaged finishes, fasteners, and fire-protection requirements still need attention.

Reinforced concrete may remain appropriate where fire performance, local construction practice, thermal mass, robustness, or other project constraints favor it. A lifecycle comparison should consider construction time, maintenance access, future modification, and operational disruption, not only the initial frame price.

How Does a 15,000 m² Warehouse Affect Unit Cost?

A large warehouse can spread engineering, mobilization, freight, and equipment costs across more floor area. Repeated bays and standardized details may also improve fabrication efficiency. This can reduce the unit cost, but it is not guaranteed.

Large facilities may need more loading docks, fire compartments, drainage capacity, paved circulation areas, utility infrastructure, and staged delivery. Long travel distances within the building and future expansion plans also affect the layout.

A mezzanine can add usable floor area without increasing the building footprint, but it also adds columns, beams, decking, stairs, barriers, fire-safety provisions, and foundation loads. The operational benefit should be tested against the added structural and service cost.

For a 15,000 m² project, early planning should address:

  • rack and material-flow layout;
  • clear height and required clear spans;
  • dock positions and vehicle circulation;
  • fire separation and egress;
  • floor loads and tolerances;
  • expansion joints and future phases;
  • drainage and utility routes;
  • fabrication, shipping, and erection sequence.

What Do Automation and Energy Systems Add to the Budget?

Automation and energy systems should be coordinated with the building before fabrication starts.

ASRS and automated handling

Automated storage and retrieval systems can require strict slab flatness, defined rack loads, precise clearances, power routes, and coordinated fire protection. The equipment supplier, structural engineer, slab designer, and building supplier should work from the same design criteria.

Cold storage and climate control

Temperature-controlled areas may require insulated panels, vapor barriers, sealed junctions, protected doors, refrigeration equipment, and condensation control. The envelope specification should reflect the target internal temperature and operating pattern.

Solar-ready roofs

If solar panels may be installed, provide the array layout and loading information during structural design. The engineer can then account for the added dead load, wind effects, attachment points, access, drainage, and maintenance requirements. A standard roof should not be assumed to accept a future array without review.

Daylighting and natural ventilation

Translucent panels and natural ventilation can reduce daytime lighting or heat buildup in suitable applications. Their placement must also consider glare, heat gain, water tightness, weather exposure, and the stored goods.

Savings and payback periods depend on system size, energy tariffs, operating hours, maintenance, and local conditions. They should be calculated for the project rather than copied from a generic table.

How to Reduce Warehouse Cost Without Weakening the Building

  1. Define the operating brief. Confirm what will be stored, how materials will move, the required clear height, rack loads, openings, temperature range, and future expansion plan. A clear brief prevents repeated redesign.
  2. Investigate the site early. Obtain the survey, geotechnical information, drainage constraints, access limitations, and available local design data before finalizing the frame and foundations.
  3. Use a rational structural grid. Repeated bays and coordinated openings can simplify fabrication and erection. The grid should serve the operation; reducing steel weight is not useful if the layout obstructs racking or vehicles.
  4. Freeze loads and openings before fabrication. Late changes to doors, canopies, solar panels, equipment, mezzanines, or suspended services can trigger redesign and rework. Resolve them before shop drawings are approved.
  5. Separate the base scope from options. Ask for a clear base package and separately priced options for insulation, skylights, ventilators, mezzanines, doors, and other accessories. This allows value engineering without hiding scope reductions.
  6. Compare quotations on the same basis. Check design loads, steel scope, cladding, coatings, accessories, engineering documents, packing, freight, taxes, erection, and exclusions. The lowest headline rate is not necessarily the lowest delivered cost.

What to Send for a Useful Warehouse Quotation

A supplier can prepare a more useful preliminary proposal when the initial request includes:

  • project country, city, and site location;
  • building use;
  • required length, width, and eave height;
  • number of spans and required clear span;
  • local wind, seismic, and other design data, if available;
  • rack, equipment, crane, mezzanine, or suspended-service requirements;
  • roof and wall panel requirements, including insulation;
  • door, window, canopy, and loading-dock openings;
  • drawings, sketches, or an equipment layout;
  • preferred delivery schedule;
  • required supply, freight, and installation scope.

Incomplete information can support an early budget, but it cannot support a final structural design or fixed project price.

Frequently Asked Questions

Can a steel warehouse be built during the Philippine typhoon season?

It may be possible, but the site program must allow for weather interruptions and safe working limits. Factory fabrication can continue under controlled conditions, while foundations, unloading, steel erection, roofing, and sealing depend on site weather. The contractor should plan lifting and temporary stability around local forecasts and approved safety procedures.

How should I estimate warehouse cost in Cebu?

Start with the site survey and geotechnical investigation, then define the building and supply scope. Port handling, inland access, unloading, local labor, drainage, and exposure conditions can all affect the budget. A Cebu estimate should use project-specific logistics and ground information rather than a national average alone.

Can solar panels be installed on a pre-engineered steel roof?

Yes, if the roof structure and attachments are designed or verified for the proposed system. Provide the panel layout, weight, mounting method, and relevant wind information before structural design. An existing roof requires an engineering review before installation.

How do I know whether the foundation needs piles?

A geotechnical investigation and foundation design determine this. Soft, variable, or reclaimed ground does not automatically mean one particular pile solution. The engineer must assess the soil profile, groundwater, building reactions, settlement limits, and available construction methods.

Which standards apply to a warehouse in the Philippines?

The project team should confirm the applicable requirements of the National Building Code of the Philippines and the NSCP edition accepted by the permitting authority, together with relevant fire, electrical, mechanical, accessibility, and local requirements. A qualified Philippine design professional should confirm the governing editions and site criteria and review the documents required for local approval.
